Continental Focus, International Reach

BW Energy Highlights Gabon Ops in Trading and Financial Update

Tuesday, October 25, 2022

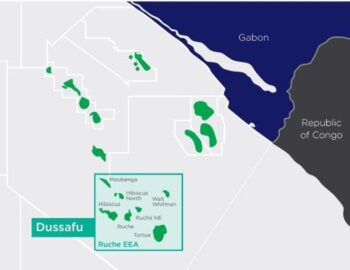

BW Energy has provided an update on the operations and development of the Dussafu Marin license in Gabon. Gross production from the Tortue field averaged approximately 10,400 barrels of oil per day in the Q3, amounting to a total gross production of approximately 960,000 barrels of oil for the period in line with expectations.

BW Energy completed one lifting in the quarter at a price of $101 per barrel. Production cost (excluding royalties) was approximately $36 per barrel. The overall production cost includes approximately $1 million related handling of the COVID-19 pandemic in the period.

BW Energy’s share of gross production was approximately 700,000 barrels of oil. The net sold volume, which is the basis for revenue recognition in the financial statement, was 715,000 barrels including 32,500 barrels of quarterly Domestic Market Obligation (DMO) deliveries with an under-lift position of 185,000 barrels at the end of the period.

BW Energy had a cash balance of $186 million on September 30, compared to $123 million on June 30. The increase is due to the payment received for the August lifting and a drawdown on the Company’s reserve-based lending (RBL) facility, partly offset by continued investments in the Hibiscus / Ruche development project.

At the start of the period, the Company had commodity price hedges for a remaining total volume of one million barrels for 2022 and 2023, of which 37% is for 2022. These were a combination of swaps and zerocost collars that will allow for future cash flow stability for ongoing development projects. BW Energy has recognized realized crude oil hedge losses in the amount of $2.9 million and unrealized gains in the amount of $14.9 million for the third quarter.

In late September, the BW MaBoMo offshore production facility arrived in Gabon on schedule. The production facility has since been installed on site and preparations are underway for future drilling operations and for the tie-in of the export pipeline to the BW Adolo FPSO and the BW MaBoMo. Twenty kilometers of the subsea pipeline has now been installed, with final connections planned for year-end.

Separately, the drilling rig is on schedule to spud the first production well planned in January. This in in line with the plan for first oil from the Hibiscus / Ruche development towards the end of the first quarter of 2023.

The Company will publish financial figures for Q3 on November 17.
